Diesel Gensets Sell Out to 2028 as AI Data Centres Drain the Backup Power Market

Diesel Gensets Sell Out to 2028 as AI Data Centres Drain the Backup Power Market

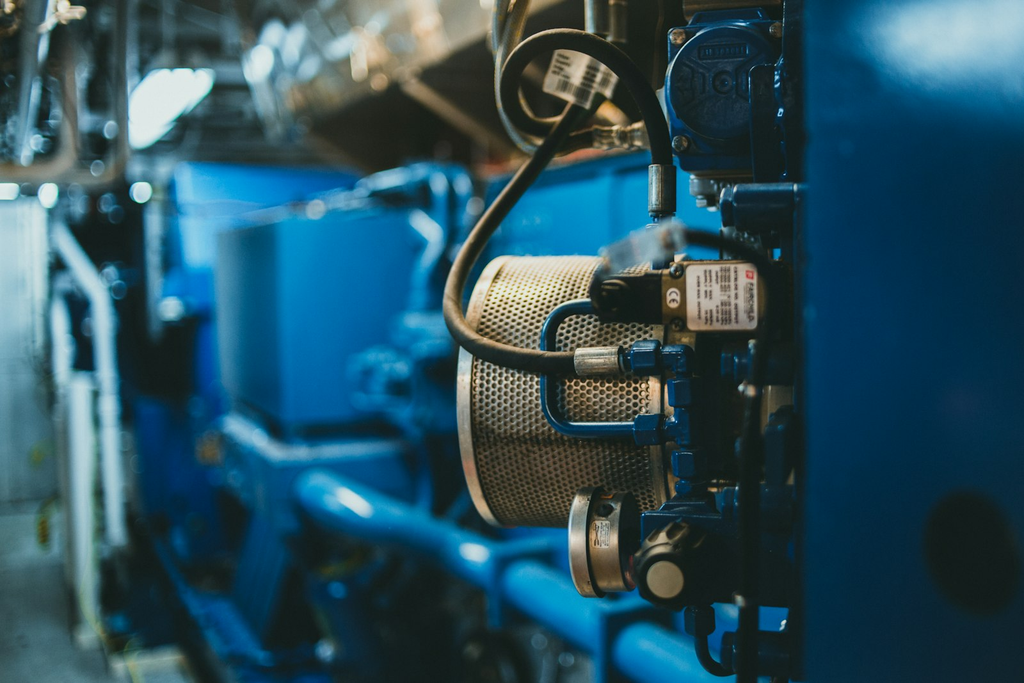

A diesel engine filter assembly on a generator set, the kind of standby equipment now on multi-year backorder.  (Photo: Jonathan Cooper / Unsplash)

China’s diesel generator export machine has a new best customer, and it is not a construction firm. Weichai Power sold more than 1,400 data centre generator sets in the first half of 2026, a figure that already exceeds its shipments for the whole of 2025, the company said in its semi-annual report released on August 27. Cummins, Caterpillar and Rolls-Royce Power Systems have all confirmed their high-power lines are booked into 2027 and 2028, with some framework agreements running to 2030. The diesel genset shortage is now the binding constraint on data centre construction schedules worldwide.

The shortage has become a scheduling problem before it is a pricing problem. Tan Jingwei, executive general manager of the digital technology development centre at China Construction Third Engineering Bureau, told an industry forum that mechanical and electrical fit-out on a data centre typically takes five to six months. Delivery lead times for core diesel generators from the major global brands, he said, have stretched to eight to twelve months since last year. The genset lead time is no longer a component that arrives when the building is ready. It now sets the date.

Rolls-Royce Power Systems says roughly 25 percent of the world’s data centres rely on its mtu Series 4000 generators for standby power, and its order book already covers projects scheduled for 2028.

Why AI Load Profiles Broke the Old Diesel Generator Sizing Rules

The technical reason behind the crunch is that AI racks draw far more power per square metre than the equipment data centres were designed around. Industry data puts AI server cabinet power density above 120 kW. Class A facilities are specified with N+1 or 2N redundant generator systems, which means a single project that used to specify a few hundred kilowatts of data centre backup power now specifies several megawatts.

That shift changes which machines get ordered, not just how many. High capacity generator sets above 2 MW, often at 10 kV or 35 kV, now account for the majority of data centre generator purchases. The specifications attached to them are unusually strict for what is nominally emergency equipment: transient voltage regulation within about 1.5 percent, start-up in eight seconds or less, and paralleling stability above 99.999 percent. Some financial-grade facilities write continuous full-load running without failure into the tender as a hard threshold, according to industry reporting.

Yang Wei, deputy director of the construction and energy institute at Beijing Telecom Planning and Design Institute, has pointed out a practical consequence that rarely appears in market forecasts. A 100 MW intelligent computing centre needs more than 100 diesel generator sets, which multiplies both the steel platform structure required to carry them and the operational complexity of maintaining them. Moving from today’s 2,000 kW units to 3,000 or 4,000 kW models would relieve some of that pressure, he said, but the machines at that scale are precisely the ones with the longest queues.

Diesel Gensets Sell Out to 2028 as AI Data Centres Drain the Backup Power Market

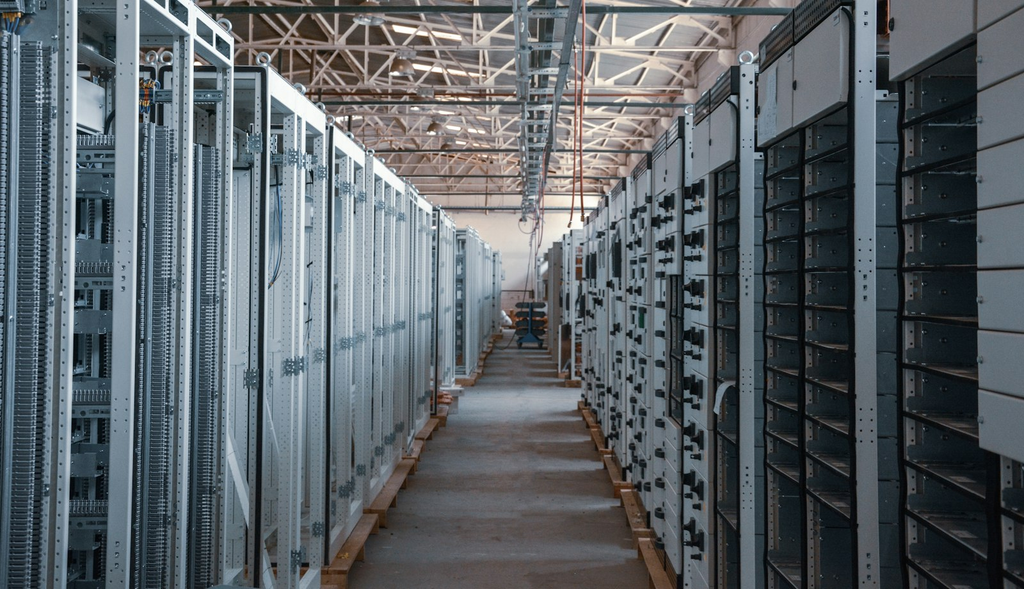

Server room aisles: density above 120 kW per cabinet has pushed standby power from hundreds of kilowatts to several megawatts per project.  (Photo: Unsplash contributor / Unsplash)

The gap between what a diesel generator price tag says and what the machine earns is a direct function of the fuel it burns. A 2 MW unit running at full load for 400 hours a year consumes roughly 400,000 litres of diesel, and at the consumption rates involved, a 10 to 20 percent fuel saving is the difference between a machine that pays for itself and one that does not. That calculus, rather than any single line item, is what has pushed operators toward hybrid configurations and toward the larger units that do more work per litre of fuel burned.

The Diesel Generator Order Book Is the Story

Rolls-Royce Power Systems has been the most explicit about capacity. Zhou Yahong, general manager of the company’s Greater China business, told Caijing that data centre backup power is one of the fastest-growing segments in global markets including China, and that the group’s global data centre business grew 35 percent in 2025. Roughly a quarter of data centres worldwide run its mtu Series 4000 units, he said, with orders already covering some 2028 projects.

The company is spending to close the gap. Its global power generation capacity is scheduled to double between 2022 and 2028, with the bulk of investment going into Germany and the United States. A plant expansion in Mankato, Minnesota, completed earlier in 2026 and output this year is expected to run about 120 percent above 2024 levels. Rolls-Royce has also lifted its medium-term target for power generation OEM revenue growth from roughly 20 percent a year through 2028 to about 25 percent a year through 2030, and plans a new generation of mtu 4000 engines with more than 20 percent higher maximum output from almost the same footprint, due in 2028.

Cummins and Caterpillar have both confirmed full order books for high-power standby generator units through 2027 and 2028. For buyers, that has turned delivery time into a purchase criterion in its own right. Industry reporting describes a market willing to pay a premium for faster delivery, which is an unusual condition in capital equipment that normally competes on price and service.

  • Rolls-Royce Power Systems. Global power generation capacity scheduled to double between 2022 and 2028, with investment concentrated in Germany and the United States. The Mankato, Minnesota expansion completed earlier in 2026 and output this year is expected to run about 120 percent above 2024.
  • Cummins. Has confirmed high-power data centre generator production capacity fully committed through 2027 and 2028.
  • Caterpillar. Same position on capacity for high-power data centre units, with the company’s historic strength in harsh-environment and mission-critical deployments.
  • Weichai Power. Has redirected capital away from hydraulic and CVT transmission programmes toward large-bore high-end engine manufacturing capacity.
  • Rolls-Royce roadmap. A new generation of mtu 4000 engines promising more than 20 percent higher maximum output from almost the same footprint, scheduled for market in 2028.

There is a second-order effect that tends to get lost in the headline numbers. Equipment that cannot be delivered on schedule does not simply delay a project; it changes its design. When the genset lead time runs past the construction programme, engineers start reworking the specifications around whatever can actually arrive, which is one reason gas generation and storage-backed configurations have moved from pilot projects to mainstream tenders so quickly.

Chinese Diesel Genset Suppliers Walk Through the Door

The squeeze has handed Chinese engine makers an opening that tariff and brand barriers had kept mostly shut. Weichai Power’s diesel generator sets entered the core supply chains of leading global data centres and major cloud providers in the first half of 2026, the company said, breaking into a segment long held by overseas brands. Its M-series high-power engines reached 6,700 units in the half, up 31.5 percent year on year.

The financial contribution is now large enough to show up at group level. Weichai reported first-half revenue of 123.16 billion yuan, up 8.8 percent, and net profit attributable to shareholders of 7.7 billion yuan, up 36.5 percent, with profit growing much faster than revenue. The power and energy segment’s share of profit rose to 20 percent. In the first quarter alone, data centre generator sets sales exceeded 500 units, up more than 240 percent year on year.

Domestic substitution has moved quickly by the standards of heavy equipment. Research estimates put the foreign share of China’s data centre generator market at about 83 percent in 2024, with domestic suppliers below 20 percent. That domestic share has since climbed above 30 percent. The China Communications Industry Association’s data centre committee tracks a similar trajectory. Market reporting suggests Chinese suppliers now hold more than half the diesel genset market in Southeast Asia and Africa, where price sensitivity and service reach matter more than brand heritage.

Diesel Gensets Sell Out to 2028 as AI Data Centres Drain the Backup Power Market

Heavy manufacturing capacity is being redirected toward high-power engines, but plant expansions take years to come online.  (Photo: Unsplash contributor / Unsplash)

What Buyers Are Actually Paying for a Standby Generator

Prices have moved steadily since 2024. Units built around imported engines are reported to have risen about 20 percent, and fully imported foreign-brand sets now exceed 3 million yuan each, roughly 445,000 US dollars at current rates. Domestic sets have tracked upward as well and now sit close to the same mark, a narrowing gap that reflects both strong demand and the fact that domestic products are no longer being positioned as budget substitutes for a standby generator.

Xu Zhiyu, a data centre architect at UCloud, described the obstacle that remains. Client confidence in century-old overseas brands is the biggest barrier, he said, and because the standby generator is only one subsystem in a data centre, buyers often scrutinise brand recognition more than performance specification. Persuading a customer takes considerable effort if a supplier is not already on the tender whitelist. Certification is part of the answer: Weichai’s gas engines have obtained CE and UL approvals, which are the entry tickets for strategic markets.

Numbers circulating from securities research give a sense of scale. One estimate puts the global diesel generator market at about 22.6 billion US dollars in 2026, corresponding to roughly 42,000 units, of which overseas demand accounts for about 35,600 units. Another puts China’s market at 12.5 billion yuan in 2025, up 53 percent year on year, and projects 18.2 billion yuan by 2028 at a compound annual growth rate of 22 percent. These are analyst projections rather than customs data and should be read as directional.

The Demand Behind the Diesel Genset Queue

None of this happens without an extraordinary wave of capital spending upstream. Alphabet raised its full-year capital expenditure guidance to between 195 billion and 205 billion US dollars in mid-July, with chief financial officer Anat Ashkenazi telling analysts that Google Cloud’s order backlog had passed 514 billion dollars and that the compute shortage would persist for at least two years. Meta lifted its own guidance from a range of 125 to 130 billion dollars up to 145 billion, with chief financial officer Susan Li saying the industry faces a long-term compute supply shortfall. Between them, Amazon, Alphabet, Microsoft and Meta disclosed capital plans approaching 800 billion dollars for the year in July alone.

China’s platform companies are running the same play. Alibaba is advancing a 380 billion yuan AI infrastructure buildout. Tencent spent 84.72 billion yuan on capital expenditure in the first half of 2026, up 82 percent year on year, with 52.78 billion yuan of that in the second quarter alone and most of it going to data centres and servers.

The load forecast explains why the diesel genset queue will not clear quickly. A McKinsey report published in June projected global data centre demand rising from roughly 82 gigawatts in 2025 to about 220 gigawatts by 2030, with AI-specific demand growing from roughly 44 to 155 gigawatts. The North American Electric Reliability Corporation has separately estimated that US data centre electricity load will reach 70 gigawatts by 2030, with average peak power shortfalls above 20 gigawatts a year between 2027 and 2030.

Gas and Fuel Cells Are Moving In

Diesel will not carry the entire load, and the alternatives are arriving on the same timeline. Lang Yun, vice-president of stationary applications sales for Rolls-Royce Power Systems in Greater China, said current high-power diesel demand is concentrated overseas, with China mainly using the 1,800 to 2,000 kW mid-power band, though appetite for larger units is growing. Rolls-Royce has introduced gas generator sets and a pure-hydrogen gas generator set, and several North American projects have deployed medium-speed gas generation at hundreds of megawatts. Lang described a dual diesel-and-gas configuration as a plausible new normal for data centre power.

The economics favour gas on running cost. Combined-cycle gas generation exceeds 60 percent thermal efficiency against above 50 percent for simple-cycle, and gas units consume 10 to 20 percent less fuel. Delivery timelines for gas units can also match construction schedules more closely, which matters when the diesel genset queue runs to 2028. Weichai has taken the same route through its subsidiary Baudouin and signed a strategic cooperation agreement with a major French customer in the first half of the year.

Fuel cells represent the longer-horizon bet. Weichai says its solid oxide fuel cell systems have reached power generation efficiency above 60 percent with more than 30 percent lower carbon emissions than natural gas generator sets, and that product development and certification preparation are complete. That is a 2030s answer to a 2026 problem, but it signals how the incumbents expect the mix to evolve.

Why the Diesel Genset Queue Will Not Clear Quickly

Heavy engine manufacturing is not a business that scales on demand signals. A large-bore engine line involves casting, machining, assembly and test capacity, and each of those stages has its own supplier base and its own lead times. Crankshafts, turbochargers, fuel injection systems and control electronics all sit on long contracts with a small number of qualified vendors. When Cummins, Caterpillar and Rolls-Royce all raise output in the same window, they compete for the same components, which is part of why announced capacity additions have not shortened quoted genset lead time as fast as buyers hoped.

Compliance work compounds the problem. A generator destined for the European Union must meet Stage V limits on particulate matter and nitrogen oxides. A unit bound for the United States follows a different certification path. Chinese exporters selling into either market need approvals before they can quote, and Weichai’s CE and UL certifications on its gas engine range are precisely the kind of credential that converts a product from an interesting alternative into a procurement-eligible option. Certification takes time that no amount of demand can compress.

Freight adds another variable. High capacity generator sets in the multi-megawatt class are heavy, oversize cargo that moves on flat racks, in breakbulk or in containers depending on dimensions, and they are subject to the same port congestion and rate volatility as any other project cargo. For a buyer weighing a domestic supplier against an imported one, the delivered cost includes those logistics, not just the ex-works price.

Emissions Rules Tighten at the Worst Moment

Regulation is adding cost precisely when supply is tight. The EU Stage V emissions standard is fully enforced, requiring particulate matter below 0.025 g/kWh and nitrogen oxides no higher than 0.4 g/kWh for units above 56 kW. China has implemented its National IV standard nationally and is piloting National V in key regions, with the use of National II and lower units to be prohibited nationwide from December 1, 2026. That deadline is now roughly two months away.

To comply, manufacturers have moved to high-pressure common rail injection with combined DOC, DPF and SCR after-treatment. Industry reporting estimates compliance has added 10 to 15 percent to research and production costs, while low-emission models now make up over 65 percent of the global market. Hybrid configurations combining diesel with storage, or with solar and storage, are reported to cut energy consumption by 20 to 40 percent and emissions by more than half compared with pure diesel sets, and sales of diesel genset products with intelligent monitoring rose 59 percent year on year.

The squeeze is real for smaller manufacturers. Battery energy storage has taken close to 8 percent of the low-end market, and Chinese firms that cannot meet the tightening emissions standard face pressure on both cost and compliance.

Where the Diesel Gensets Are Going

The geographic split of demand has shifted in ways that matter for exporters. Asia-Pacific accounts for the largest regional share of the global generator market, supported by data centre construction and industrial buildout in China, India and Vietnam. North America runs second on the strength of hyperscale construction and grid resilience spending, and it is the region where the highest-power units concentrate. Europe follows, shaped more by emissions rules and automation demand than by raw capacity growth. The Middle East and Africa take a smaller share but are growing quickly from a low base, driven by remote mining, oil and gas operations and emergency power where grid coverage is thin.

Telecommunications remains the single largest end-user category by volume, with base stations accounting for roughly a third of global demand. Around 35 percent of base stations sit in areas with unstable grid coverage, and those sites need continuous rather than standby power. That segment buys smaller units in large numbers, which is a different business from the multi-megawatt orders that dominate the headlines, and it is the segment where Chinese suppliers have built their deepest volume position.

Construction, mining and oil and gas together account for roughly a quarter of global demand, mostly in the small and medium sizes deployed off-grid. That demand is steadier than the data centre boom and less sensitive to the AI capital cycle, which is some cushion for suppliers if hyperscale spending cools. It is also the segment most exposed to battery storage substitution, since the duty cycle is predictable enough for storage to compete.

What Happens Next for Diesel Generator Exporters

Three things are worth watching over the next two quarters. The first is whether plant expansions actually deliver. Rolls-Royce’s Mankato line is running and its 2028 engine is on the roadmap, and Weichai has reallocated capital from hydraulic and CVT programmes toward large-bore engine capacity. Capacity additions in heavy engines take years, so the order book is unlikely to shorten before 2028 even if demand flattens.

The second is the December 1 emissions standard deadline in China. Any operator holding older units faces a hard cut-off, which could pull forward replacement orders and tighten the mid-power segment further.

The third is whether Chinese suppliers convert their current opening into a durable position or a cyclical one. Goldman Sachs has projected that Weichai’s data centre generator business could grow from about 10 percent of group net profit to roughly a third by 2030, which would make an industrial engine maker into an AI power infrastructure supplier. JPMorgan Chase has made a similar argument. That re-rating rests on delivery reliability at scale, not on a single good half-year.

For anyone specifying standby power today, the practical advice is unglamorous. Order early, confirm the certification path for the destination market, and treat genset lead time as a line item in the construction schedule rather than an assumption. The standby generator has become the long pole in the data centre build, and it will stay that way until the new engine plants ramp.

KEY TAKEAWAYS

  • Weichai Power sold over 1,400 data centre generator sets in H1 2026, more than all of 2025, with data centre engine sales up more than 240 percent year on year in Q1.
  • Cummins, Caterpillar and Rolls-Royce have confirmed high-power capacity booked into 2027-2028, with some framework agreements extending to 2030.
  • Genset lead time has stretched to 8-12 months against 5-6 month construction fit-out schedules, making diesel generator availability the binding constraint on data centre delivery.
  • AI rack density above 120 kW and N+1 or 2N redundancy have pushed single-project data centre backup power demand from hundreds of kilowatts to several megawatts, favouring high capacity generator sets above 2 MW.
  • Domestic substitution in China has risen from under 20 percent in 2024 to above 30 percent, with CE and UL certification opening strategic export markets for Chinese diesel genset brands.
  • China’s ban on National II and lower units takes effect December 1, 2026, tightening the emissions standard and potentially pulling forward replacement demand.

Sources

Weichai Power 2026 semi-annual report coverage (September 10, 2026) — https://www.financialcontent.com/article/marketersmedia-2026-9-10-from-narrative-to-realized-growth-under-the-aidc-wave-weichai-powers-data-center-generator-sales-in-the-first-half-of-2026-surpass-full-year-sales-of-last-year

AI compute expansion and backup power shortage, reporting on Cummins, Caterpillar and Rolls-Royce order books — https://finance.biggo.com/news/8c40f088-87e4-420c-bf73-9c3f0b0cb5c2

China’s power generator exports, General Administration of Customs data via China Daily (April 2026) — https://investinchina.chinaservicesinfo.com/s/202604/15/WS69df51cf498e23165e06ecaf/exports-of-chinas-power-generators-up.html

General Administration of Customs statistics portal — http://stats.customs.gov.cn/indexEn

This report draws on company disclosures, customs statistics and industry conference commentary. Figures attributed to securities research and market forecasts are projections rather than confirmed results and are labelled as such. Emissions thresholds, tariff positions and delivery lead times change frequently and should be verified against the relevant authority or supplier before being relied on for procurement.
